Biannual Update on Paving Plan

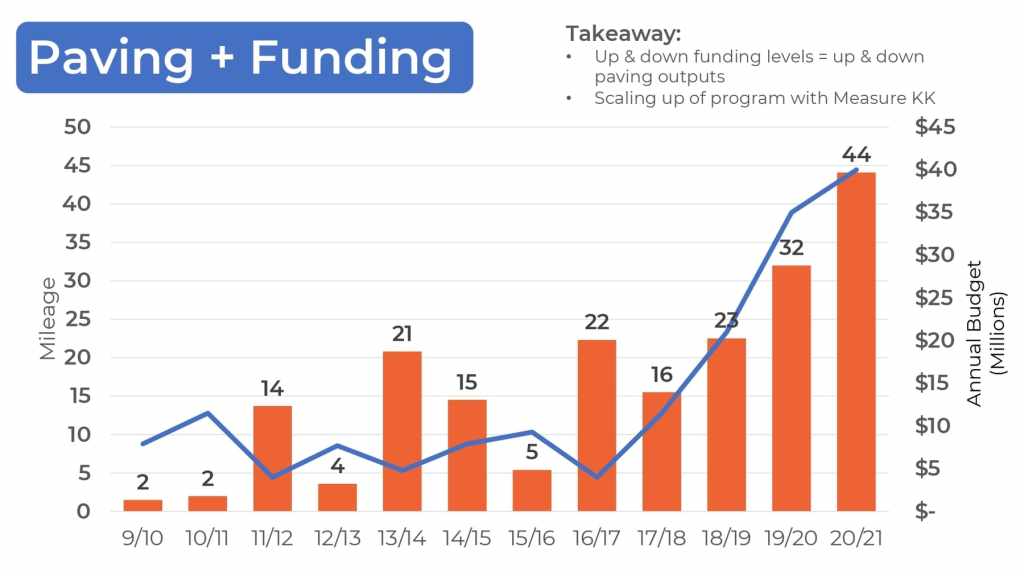

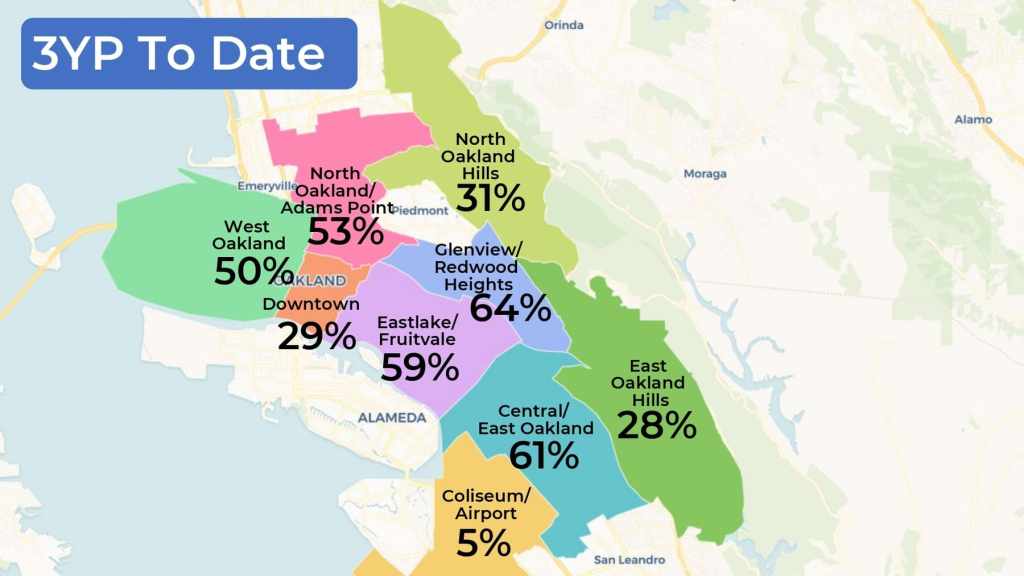

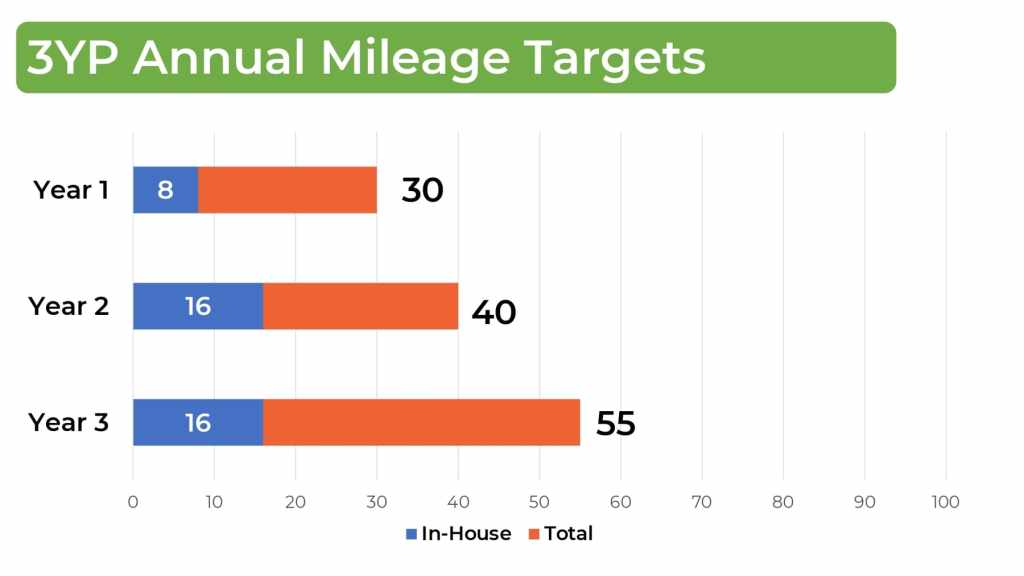

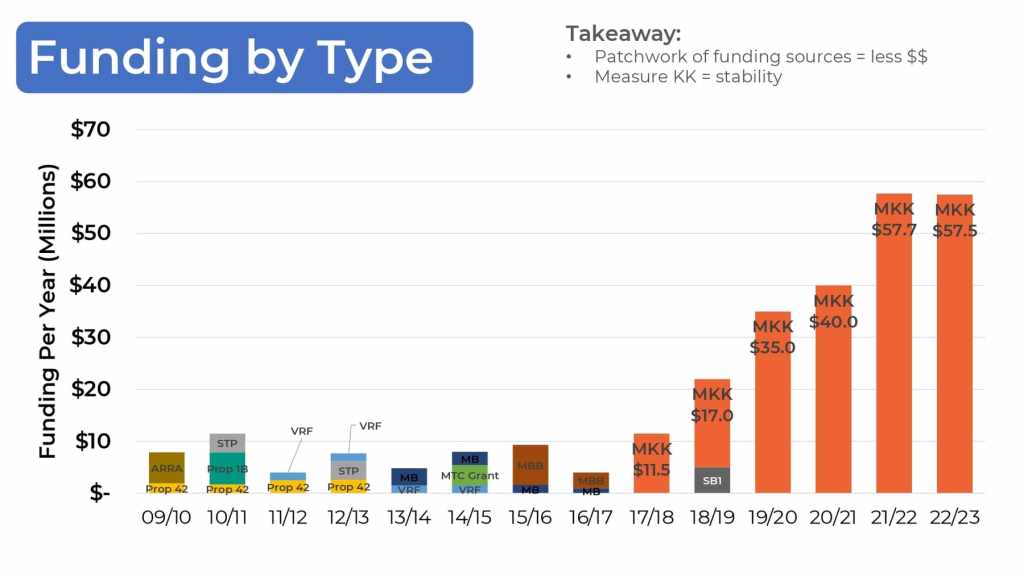

At the August 19, 2021 BPAC meeting, Sarah Fine, OakDOT Paving Program Manager, provided the biannual update on the 2019 3-Year Paving Plan. An excerpt is below, followed by the full presentation.

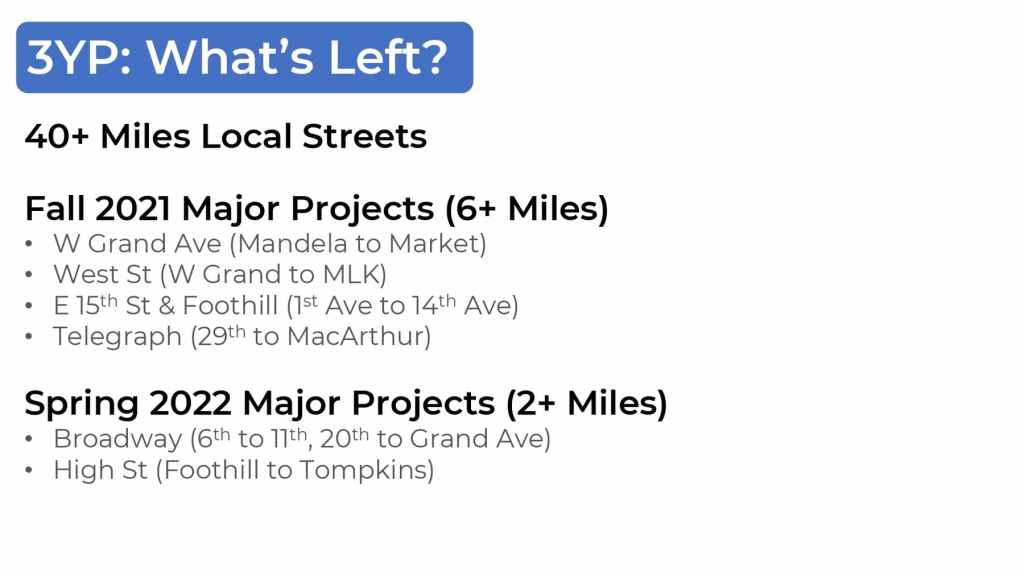

3-Year Paving Plan — Remaining

40+ Miles Local Streets

Fall 2021 Major Projects (6+ Miles)

  • W Grand Ave (Mandela to Market)
  • West St (W Grand to MLK)
  • E 15th St & Foothill (1st Ave to 14th Ave)
  • Telegraph (29th to MacArthur)

Spring 2022 Major Projects (2+ Miles)

  • Broadway (6th to 11th, 20th to Grand Ave)
  • High St (Foothill to Tompkins)

3-Year Paving Plan — Not Deliverable by June 2022

Major Projects (7+ Miles)

  • 14th St (Brush to Oak) (ATP Grant Coordination)
  • 52nd St (MLK to Shattuck) ([Lack of] Staff resources)
  • 7th St (Mandela to Market) (ATP Grant Coordination)
  • Broadway (Embarcadero to 6th) (Pending Oakland A’s)
  • Franklin (6th to Broadway) (Staff resources)
  • Grand Ave (Broadway to MacArthur) (Staff resources)
  • Lakeside Dr (Jackson to E 12th St) (Staff resources)
  • MLK (47th to City Limit) (Staff resources)

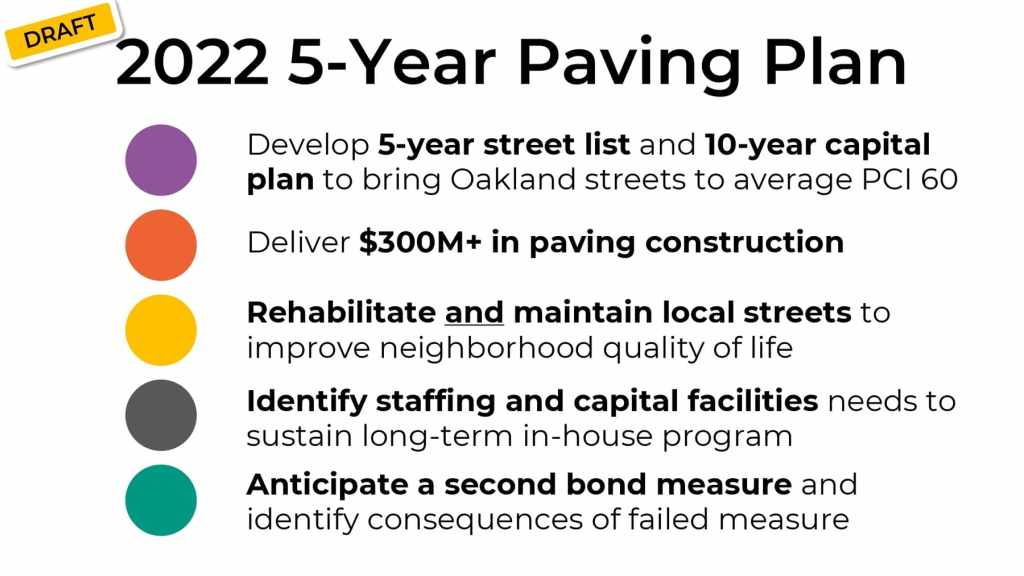

Draft 2022 5-Year Paving Plan

  • Develop 5-year street list and 10-year capital plan to bring Oakland streets to average PCI 60
  • Deliver $300M+ in paving construction Rehabilitate and maintain local streets to improve neighborhood quality of life
  • Identify staffing and capital facilities needs to sustain long-term in-house program
  • Anticipate a second bond measure and identify consequences of failed measure

Presentation

Leave a Reply

Fill in your details below or click an icon to log in:

WordPress.com Logo

You are commenting using your WordPress.com account. Log Out /  Change )

Facebook photo

You are commenting using your Facebook account. Log Out /  Change )

Connecting to %s
