Link21 Update

At the May 2, 2024 BPAC Infrastructure Committee meeting, Brian Soland and Darin Ranelletti from BART’s Planning and Development team will present an informational update on the Link21 project.

The Vision — Link21 and its partners will:

  • Transform the BART and Regional Rail network into a more integrated system.
  • Provide a faster, more connected, equitable, affordable, & accessible train service​.
  • Include a new transbay passenger rail crossing.

Oakland considerations

  • A new central transportation hub for the megaregion
  • Improved access to jobs and destinations for Oaklanders
  • Alignment with Oakland plans
  • Improved safety, health, and air quality for Oaklanders
  • Substantial investment to advance equity
  • Potential new alignment and stations will be assessed in future phases

The presentation is below, followed by notes from the presentation and discussion.

Presentation

Presentation notes

  • Goal of providing more service, more destinations, new underground connection SF to East bay with connections to rail.
  • Project team is taking info on project to public and joint power authority boards over next few months—here to coordinate with key stakeholders.
  • Background: analyzing how new crossing could benefit megaregion
    • Inequitable service that doesn’t meet needs of equity needs populations
    • Congestion on key corridors; existing transbay capacity insufficient
    • Limited service reliability
  • Vision: Link21 and its partners will transform BART and Regional rail network into more integrated system.
  • Faster, more connected, more equitable and affordable train service.
  • Reaching decision point: Either a standard gauge crossing connected with the regional rail network (such as Caltrain and Capitol Corridor); or a broad gauge connection to the BART network.
  • Goal is to transform passenger experience, promote equity / livability, support econ opportunity;
  • Equity commitment: seeking to elevate equity in planning process—established an equity advisory council (including 4 members from Oakland).
  • Oakland engagement
    • Equity advisory council
    • Monthly meetings with Oakland and port
    • Community engagement events — such as rose foundation, open houses

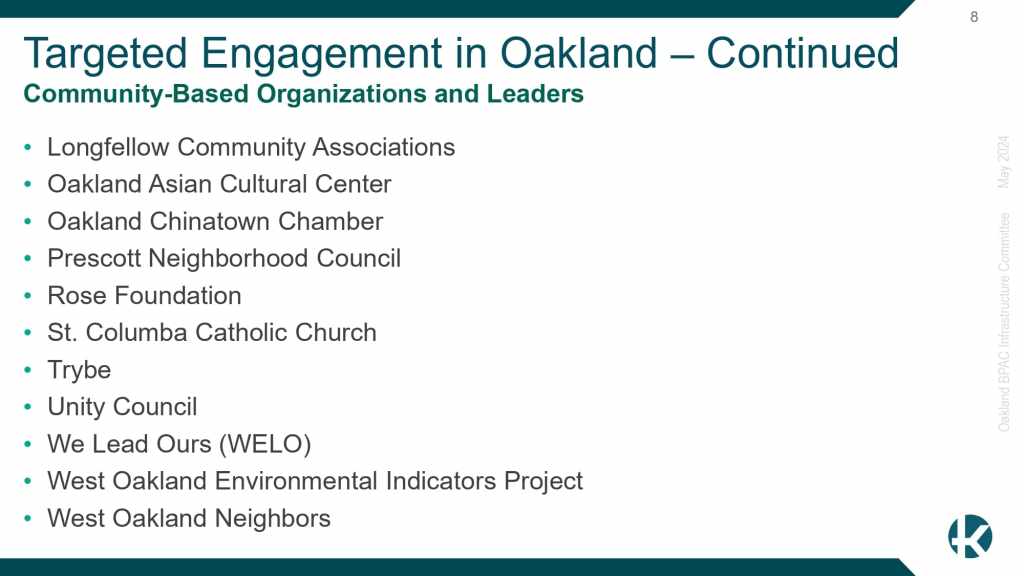

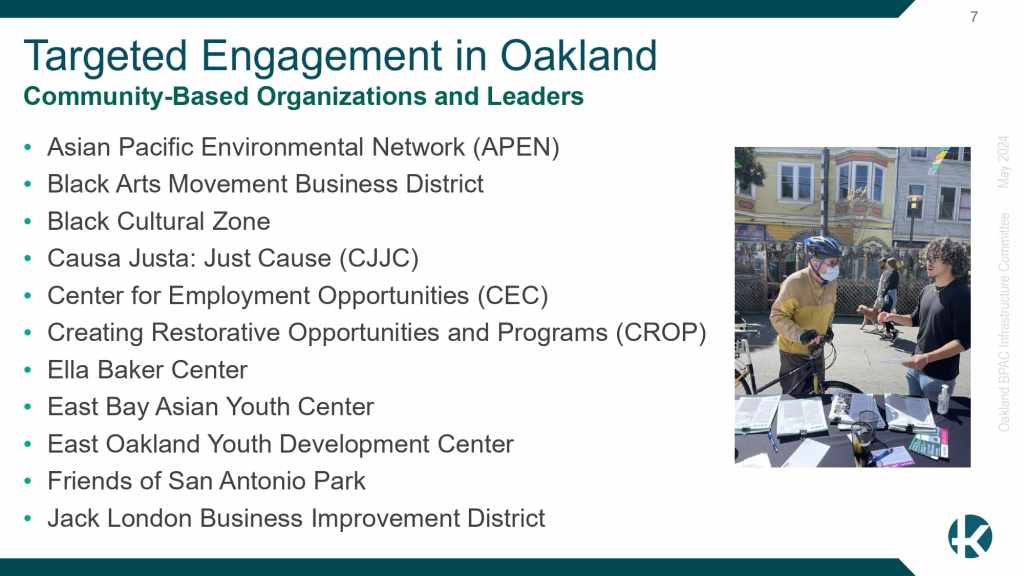

    • Targeted engagement with some community based orgs and leaders
  • Feedback:
    • Need to improve rider experience, reliability, safety, affordability

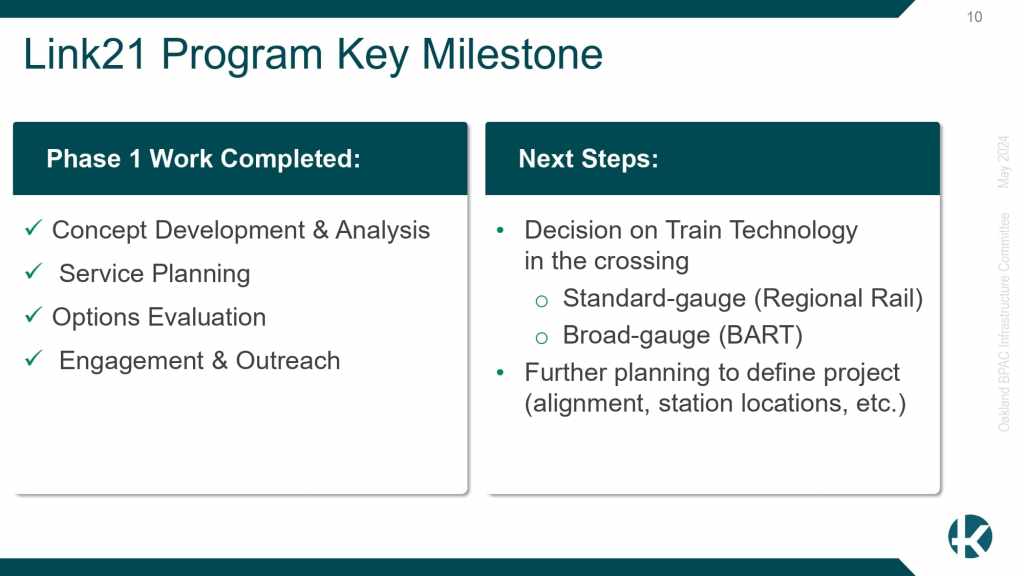

  • Still in phase 1 of project planning (concept development and analysis, service planning, options evaluation, outreach.
  • Next steps:
    • Decision on train tech in the crossing (standard gauge v. Broad Gauge)
    • Further planning to define project (alignment, station locations)

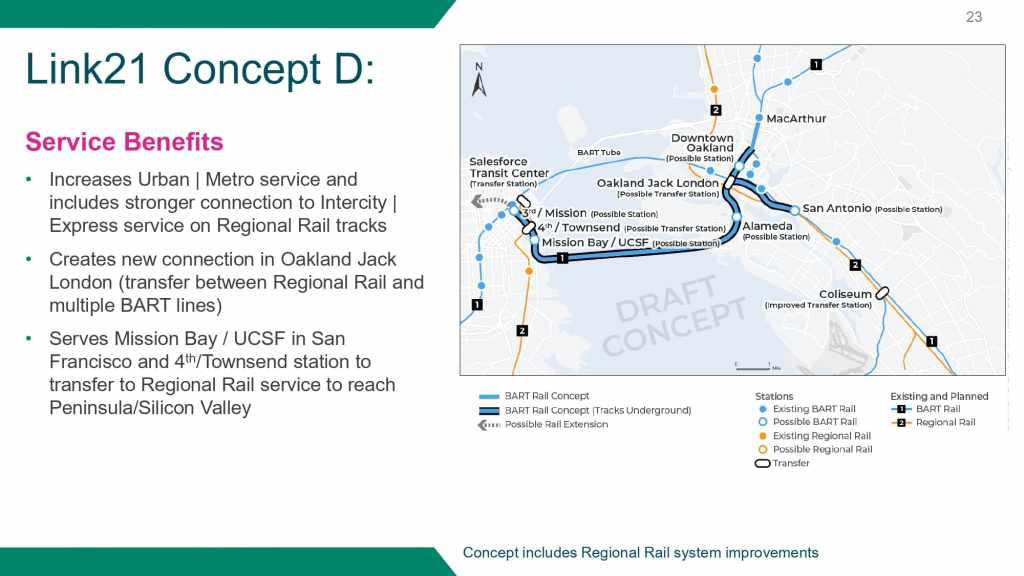

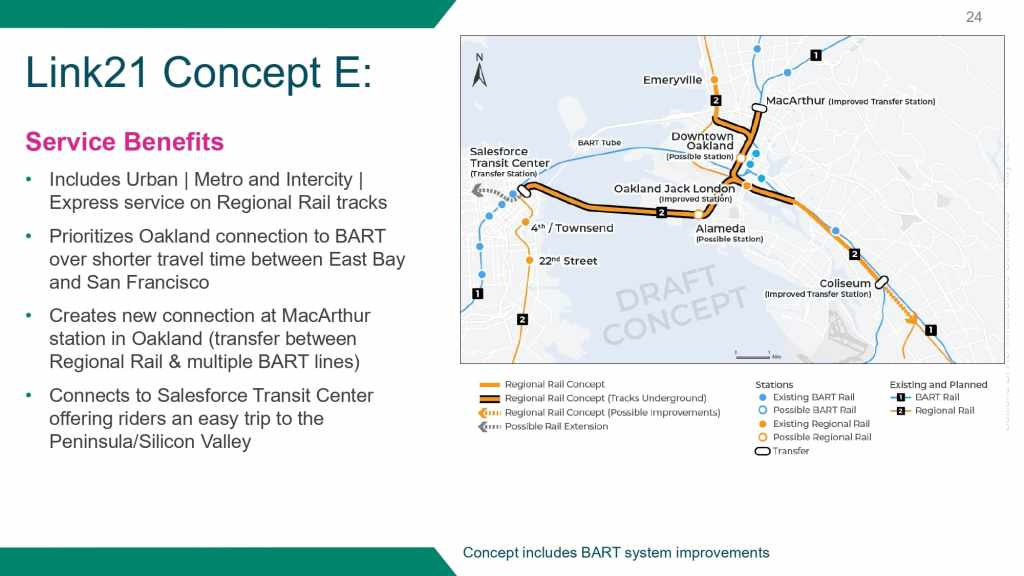

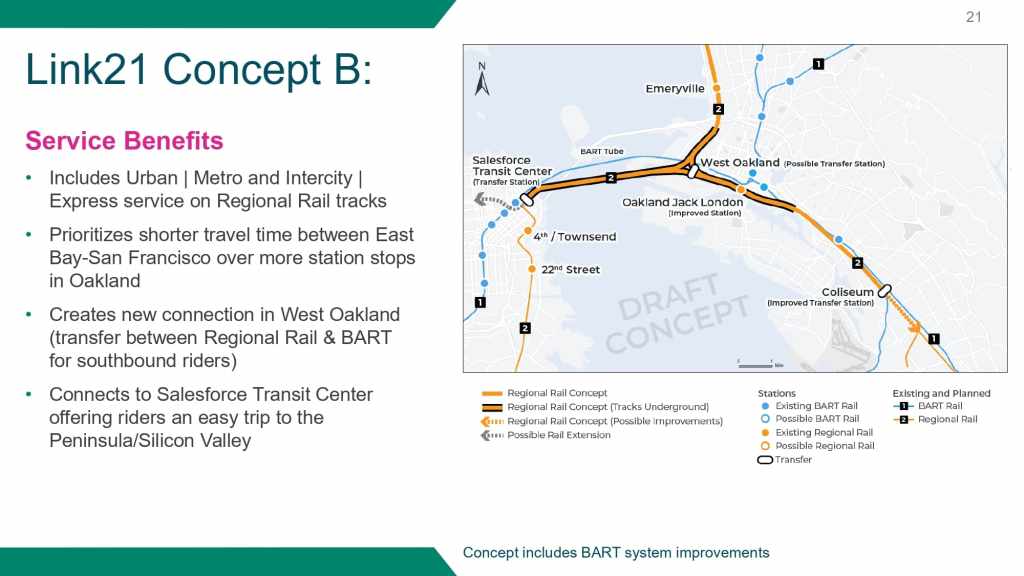

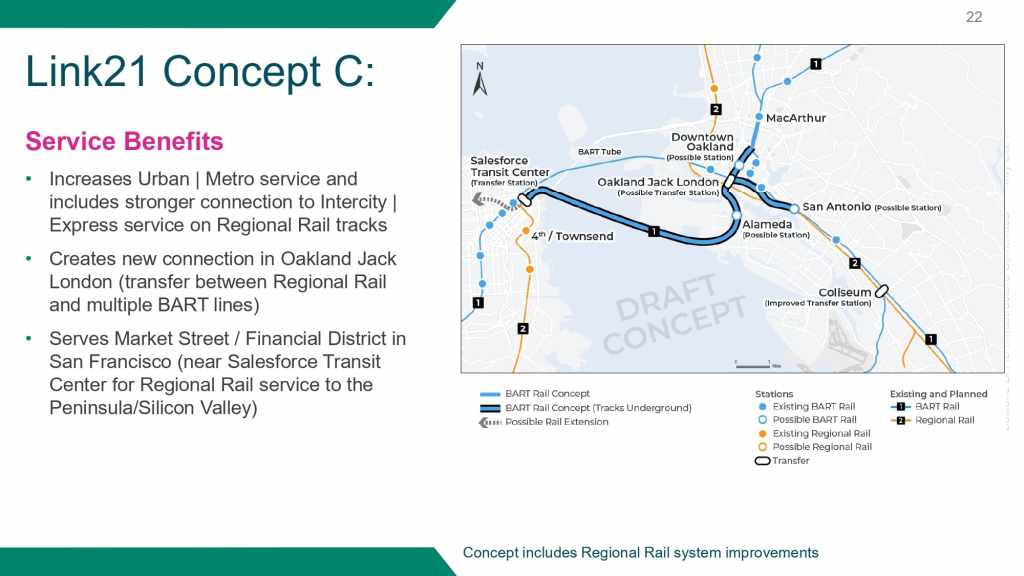

  • Standard gauge crossing: connect with Capitol Corridor and Caltrain—including Caltrain in the urban metro service; gives a 2 for 1 opportunity—have 2 service types—could have fast BART like service using this service – potential for direct connections to peninsula;
    • Benefits for Oakland: potential one seat rides between Oakland and the Peninsula, Emeryville, West Berkeley; faster and better connected rails service to Sacramento, Stockton, I-80 corridor; new rail transfer hub in Downtown Oakland; new alignment would be underground through Oakland.
  • Broad Gauge crossing: (accommodate only BART):
    • Direct BART connection from Oakland to Alameda, mission bay, and SOMA – new transfer station at Jack London Square; heard interest in San Antonio infill station regardless of track gauge.
    • Alignment would be underground.
  • Findings so far:

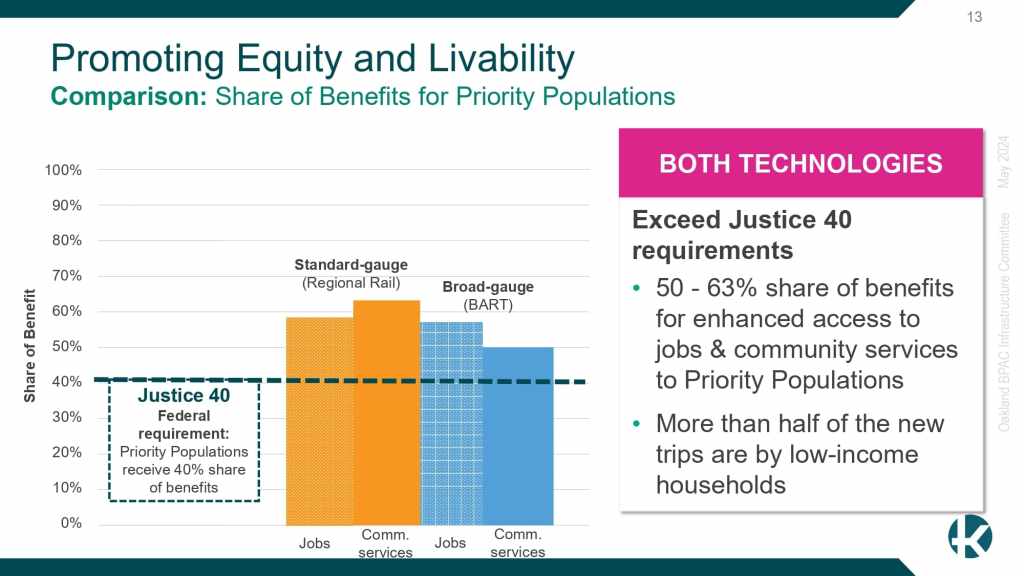

    • Comparisons: both provide benefits beyond Justice 40 requirements.
    • Majority of new trips in both options would be taken by low income households.
    • Access to stations and jobs: both support economic opportunities.

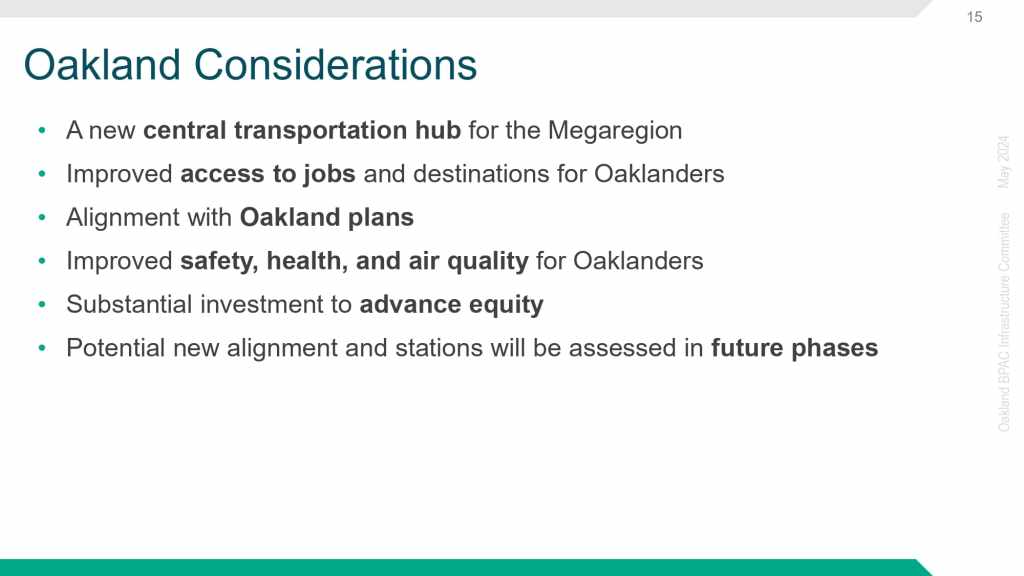

  • Oakland considerations
    • A new central transportation hub for megaregions
    • Improved access to jobs and destinations
    • Alignment with Oakland plans
    • Improved safety, health and air quality
    • Substantial investment to advance equity
    • Potential new alignment and stations will be assessed in future phases (thinking about wider land use integration and designs

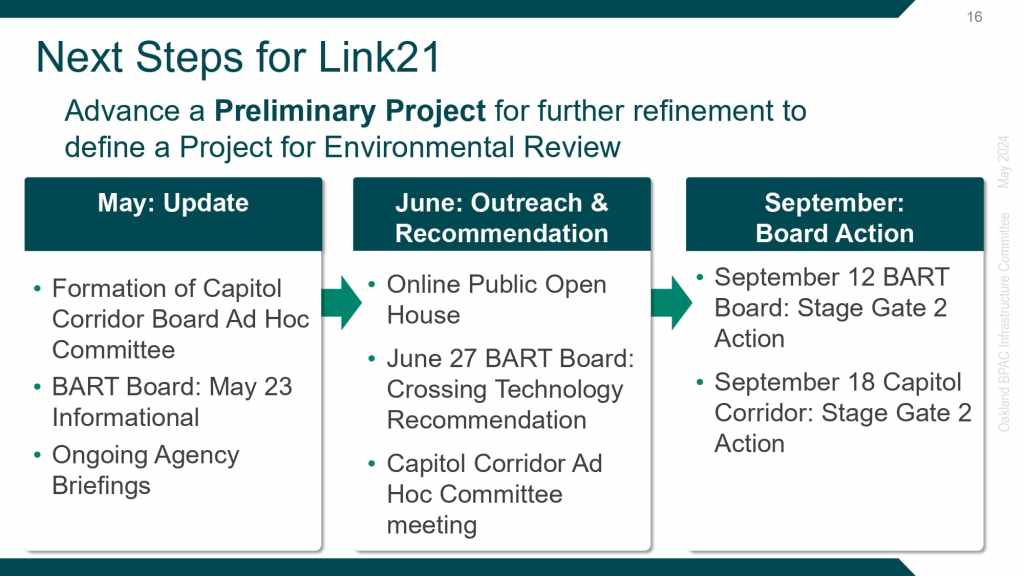

  • Next steps
    • May 23: update to BART board
    • June 27: – BART board crossing technology recommendation
    • Sept: back to BART board and Capitol Corridor for decision

Discussion notes

  • How will they make the decision?
  • Are there going to be two transfer points?
    • Yes, Downtown Oakland and SF Transbay terminal.
  • For a Jack London Square location, would it be close to amtrak?
    • It’s too early to say (ideally would be aligned with existing station); potential for new below grade connection to Oakland (underground just south of Emeryville and continues below grade and come up along corridor between Coliseum and Fruitvale.
  • Standard gauge crossing: would that just be capitol corridor?
    • A: Governance not yet determined—could be Caltrain crossing into East Bay; Capitol Corridor trains could use—operator agnostic right now.
    • Still very early to determine operating costs.
  • Regional rail would make more sense to take super commuters off the freeways.
  • Decision on track gauge is the primary issue for this year; the next stage is dependent on funding but could begin as early as this year or next year.
  • Question about whether it would make sense to talk about i.e. adding bus only lane on bridge.
    • There was a decision to focus only on rail in Stage 1.
  • Is Caltrain a decision-making member?
    • At this point it’s just BART and Capitol corridor but have a robust community engagement.
  • There’s no 24-hour service now – would like to address this and the importance of Clipper integration.
    • Having a second crossing connection could alleviate bottleneck for enabling late night service—discussing internally at BART—what other policy changes would be needed; it’s a step in the right direction. One crossing could cover service when another is out of service.
